Cost Analysis of Bathroom Remodel Permits California: What to Expect Ask ten homeowners what a California bathroom remodel permit costs, and you'll get ten different answers. That's because the price has little to do with the word "bathroom" itself. It depends on your project's scope, its declared valuation, your jurisdiction, and how much it touches plumbing, electrical, structural, or mechanical systems.

California has no single statewide flat permit fee. Your city or county building department sets its own application, plan review, issuance, and inspection charges. This guide walks through realistic project scenarios, the individual cost components, what pushes costs up or down, and how to build a permit budget you can trust.

Key Takeaways

  • Cosmetic-only updates may be permit-exempt locally; plumbing, electrical, structural, or layout changes usually require permits.
  • Budget for separate building, plumbing, electrical, mechanical, plan review, inspection, and revision fees, not one flat bathroom permit charge.
  • Simple same-location work costs less; relocated fixtures, structural changes, or additions cost more.
  • Base your budget on your property's jurisdiction and documented scope, not a generic statewide number.

How Much Does a Bathroom Remodel Permit Cost in California?

There's no single "California price." Costs vary by city, county, and project type, so treat every number here as a jurisdiction-specific benchmark, not a universal quote.

Typical Cost Scenarios

Scenario Benchmark jurisdiction What you pay (gov. fees)
Cosmetic / finish-only Los Angeles County Often $0 if truly exempt
Same-layout remodel San Diego $440.82 per dwelling unit
Extensive / structural remodel San Diego $3,512.92 plan check + $2,228.29 inspection, plus per-500 sq ft increments
Valuation-based fees Beverly Hills Plumbing and electrical each at 8.33% of project valuation

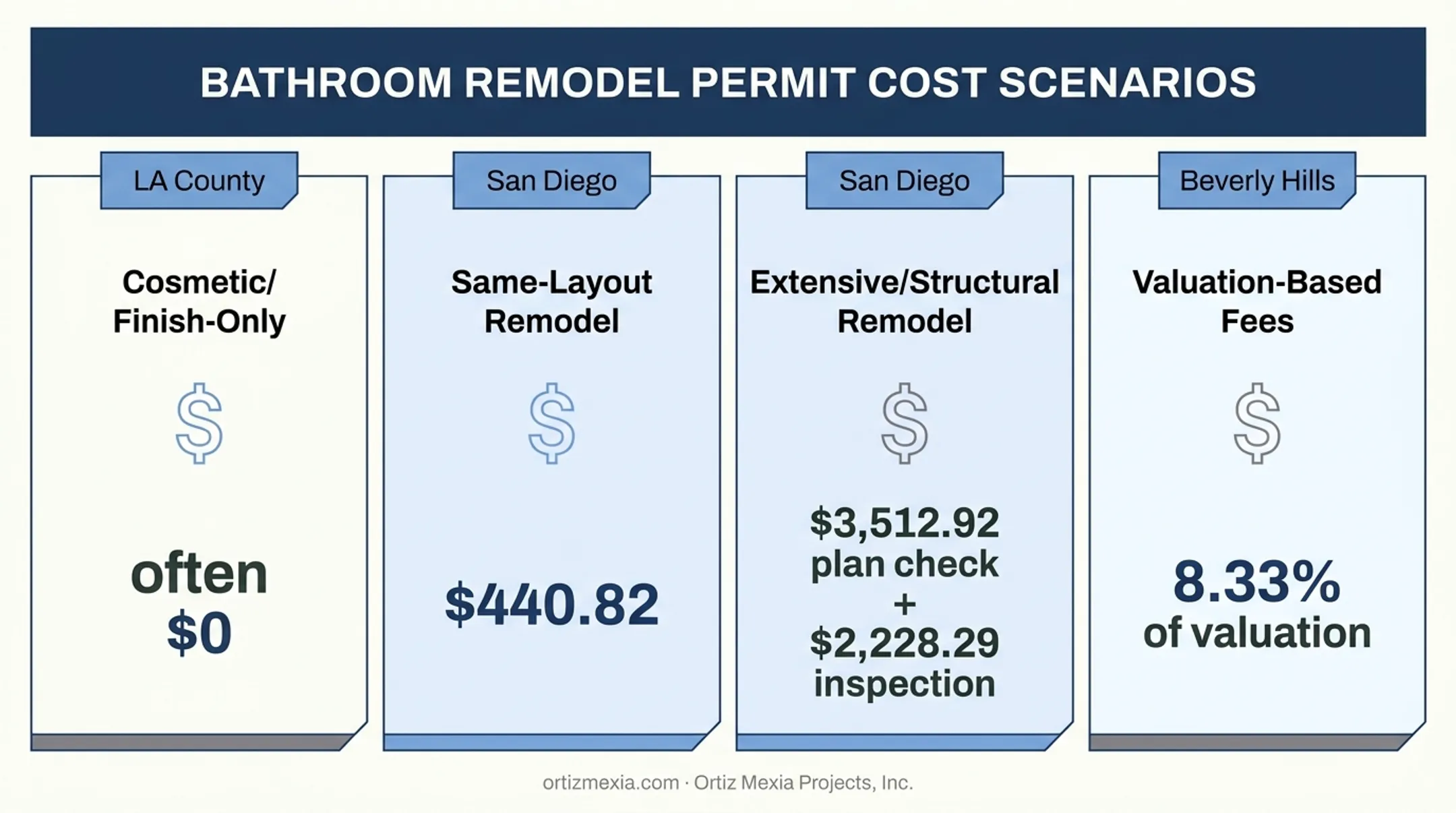

California bathroom permit cost comparison across four jurisdiction scenarios

Cosmetic or potentially permit-exempt work. Los Angeles County exempts finish work such as painting, tiling, cabinets, and countertops when disability-access rules don't apply. The exemption does not cover electrical or plumbing changes, and it applies to LA County—not necessarily the City of Los Angeles or other jurisdictions. Always confirm locally.

Permitted same-layout remodel. San Diego's May 2026 fee schedule lists $440.82 per dwelling unit for a residential bathroom remodel with no structural or wall-framing changes and no added fixtures. That amount is a no-plan combination permit covering mechanical, electrical, and plumbing together.

Extensive remodel or bathroom addition. San Diego's addition/remodel schedule lists a base of $3,512.92 for plan check plus $2,228.29 for inspection, with added increments per 500 square feet for structural work.

Beverly Hills calculates fees off total project valuation, with plumbing and electrical each charged at 8.33% of valuation.

These figures cover government fees only. They do not include:

  • Architectural drawings
  • Permit expediting
  • Contractor labor or materials
  • Correction work after failed inspections

A fee schedule from San Diego or Beverly Hills tells you nothing about what your own city or county charges. Incorporated cities and unincorporated county areas often run entirely separate schedules.

What Goes Into the Cost of a California Bathroom Remodel Permit?

Your remodeling budget and your permit budget are two different things. Permit costs cover approvals, plan review, issuance, and inspections—not tile, fixtures, or labor. What you pay depends on permit configuration, how fees are calculated, plan review, inspections, and any corrections or special requirements.

Permit Type or Configuration

Some jurisdictions combine building, plumbing, electrical, and mechanical work into one permit. Others require separate applications for each trade:

  • Relocated drains often need a separate plumbing permit
  • New circuits or GFCI outlets may require an electrical permit
  • Exhaust-fan changes can trigger mechanical review
  • Wall alterations or a new bathroom layout typically need a building permit plus trade permits

Verify with your local department whether they combine or separate these.

Fee Calculation and Project Valuation

Jurisdictions calculate fees differently:

  • Beverly Hills uses stepped valuation brackets starting at $77 for the first $500 of construction value
  • San Diego uses fixed line items by fixture, circuit, or equipment count
  • Los Angeles uses valuation tables plus trade-specific schedules

If you understate declared valuation, the department can correct fees later, so document scope accurately from the start.

Plan Review and Document Preparation

Plan review charges cover checking floor plans, plumbing layouts, electrical diagrams, structural details, and energy documentation. Beverly Hills lists plan check at 80% of the total permit fee, with a $51 minimum for plumbing, electrical, and mechanical reviews. This is separate from what you'd pay an architect or drafter to prepare those documents.

Inspections and Permit Issuance

Depending on scope, expect inspections at:

  1. Rough plumbing (before walls close up)
  2. Electrical wiring
  3. Framing (if walls or structure change)
  4. Ventilation
  5. Final completion

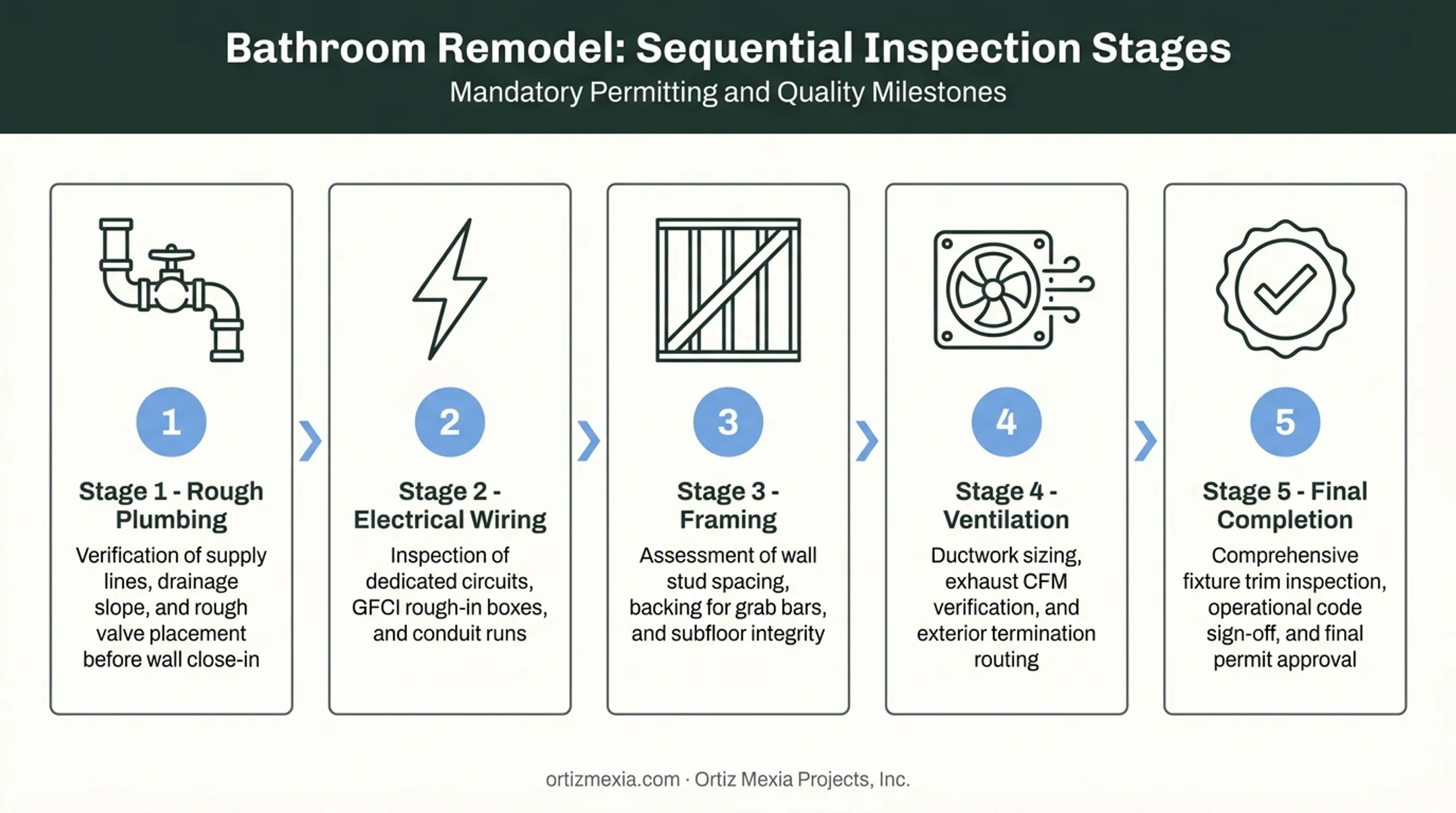

Five-stage bathroom remodel inspection sequence from plumbing to completion

LADBS requires at least 24 hours' notice for inspections and won't let work continue past a required inspection point without approval.

Corrections, Resubmittals, and Special Requirements

Incomplete plans or missed details trigger correction notices and another review cycle. San Diego requires all disciplines' corrections to be consolidated before resubmittal, adding time even when the fix is minor.

Additional cost drivers include:

  • Expedited processing requests
  • Historic-property review (relevant for older LA neighborhoods)
  • Zoning questions tied to setbacks or lot coverage
  • Site-specific conditions like slope or drainage

A bathroom addition or structural change almost always demands more documentation than a same-footprint remodel, even if the finished space looks similar in size.

Low-Cost vs High-Cost Bathroom Permit Scenarios

"Low cost" and "high cost" here describe permitting complexity, not whether you install a $30 faucet or a $3,000 one.

Scope and Permit Complexity

Lower-cost scenario: Same-location fixture swaps with no changes to plumbing routing, electrical circuits, or walls. Some of this may even be exempt, pending local confirmation.

Higher-cost scenario: Work that usually triggers multi-department review, such as:

  • Relocated fixtures
  • New electrical circuits
  • Modified ventilation
  • Wall or framing changes
  • A bathroom addition or room conversion

These projects typically need coordinated review across building, plumbing, electrical, and mechanical departments.

Plans, Review, and Long-Term Risk

A simple remodel usually means simpler drawings and a shorter review path. A complex one means detailed plans, multiple review rounds, staged inspections, and correction cycles.

Paying for complete plans and the correct permits upfront reduces the risk of:

  • Stop-work orders mid-construction
  • Concealed unpermitted work surfacing during resale
  • Insurance claim disputes
  • Costly rework to bring unpermitted changes into compliance

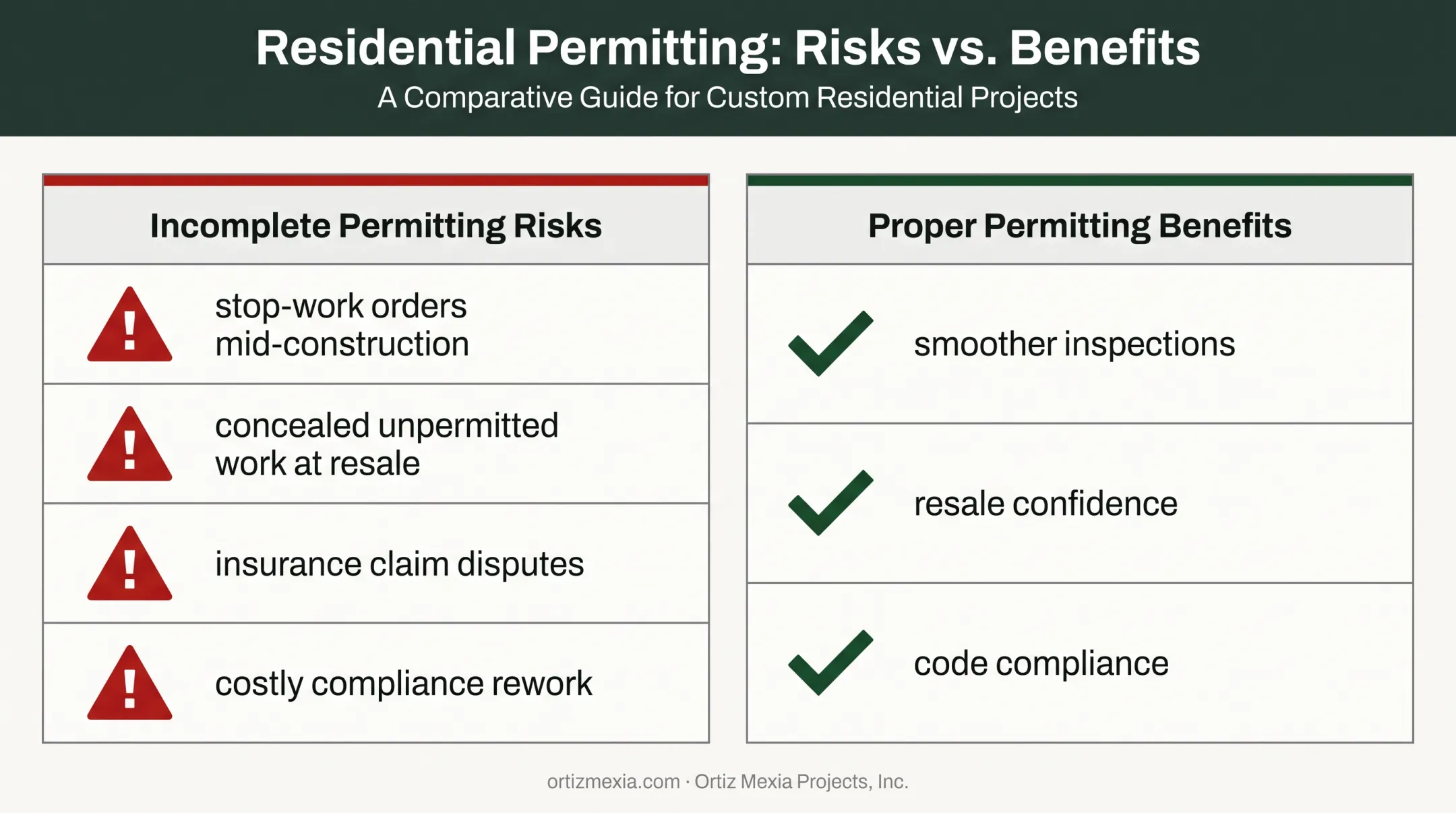

Risks of incomplete bathroom remodel permitting versus proper permit compliance

The California Building Standards Commission confirms that the 2025 Triennial Edition of Title 24 took effect January 1, 2026. Local jurisdictions can add their own amendments on top of that baseline, so incomplete permitting often costs more once corrections stack up.

How to Estimate the Right Permit Budget

The most reliable estimate starts with your property address and a written scope of work, matched to the correct building department.

Confirm the Jurisdiction and Scope

First, determine if your property sits inside an incorporated city or an unincorporated county area; the fee schedule and rules differ. Then list every planned change:

  • Fixture locations (staying put or relocating?)
  • Walls (removed, added, or modified?)
  • Circuits and outlets
  • Exhaust fan or ventilation changes
  • Windows
  • Room dimensions

A remodel of an existing bathroom is a different animal from adding one in a new area. Additions often bring extra zoning, structural, and drainage documentation into play.

Build the Estimate From Official Sources

Check your local building department's current fee schedule, permit application requirements, valuation method, and inspection list. Many departments also allow a pre-application consultation or written fee estimate request when scope is unclear. This won't guarantee a specific timeline, but it beats guessing.

Add Non-Government Project Costs

Your permit fee is only one line in the full budget. Add separate lines for:

  • Architectural or drafting services
  • Structural or engineering input (if walls or framing change)
  • Permit coordination
  • Contractor labor and materials
  • Demolition and utility upgrades
  • Inspection corrections
  • Contingency funds

Full bathroom remodel budget breakdown beyond government permit fees

A low permit fee doesn't guarantee a cheap remodel, and a higher fee often just reflects a larger declared valuation or more involved review, not a penalty.

For Los Angeles homeowners who need coordinated design, drawings, and permit support, Ortiz Mexia Projects, Inc. handles building permit procurement for single-family homes through 4-unit residential buildings across greater Los Angeles, Santa Monica, and Beverly Hills.

Its Custom Residential Design service covers permitting alongside design, contractor bidding, and construction through Certificate of Occupancy. That support applies within its stated service area—not statewide coverage or contractor licensing.

What Most People Miss When It Comes to Bathroom Permit Costs

Homeowners often budget only for the initial permit fee and stop there. That leaves out:

  • Plan review charges
  • Separate trade permits for plumbing, electrical, or mechanical work
  • Revision or resubmittal cycles
  • Inspection correction fees
  • Professional document-preparation costs

A layout change can ripple beyond plumbing. Moving a wall might trigger electrical rewiring, ventilation reconfiguration, structural review, energy code compliance, or even accessibility considerations, all before the first pipe is touched.

Finally, don't rely on an old blog post, a forum thread, or a neighbor's invoice from three years ago. Fee schedules change. Confirm current numbers with the building department that has jurisdiction over your specific address.

Conclusion

California bathroom permit costs shift based on jurisdiction, project valuation, permit type, design complexity, required plans, and how much plumbing, electrical, structural, or mechanical work is involved. There's no shortcut around that variability.

Build the most dependable budget from your local government's fee schedule plus realistic design and construction costs. Confirming requirements before demolition starts protects your timeline, your compliance, and your property's long-term value.

Frequently Asked Questions

Do I need a permit to remodel a bathroom in California?

Permits commonly apply when plumbing, electrical, structural, ventilation, or layout changes are involved. Some purely cosmetic work may be exempt. Confirm exemptions with your local city or county building department before starting.

How much does a permit to add a bathroom cost in California?

A bathroom addition may require several approvals, and costs depend on jurisdiction, declared valuation, plans, site conditions, and trade work involved. Check your local building department's current fee schedule rather than relying on a universal figure.

What does a $10,000 bathroom remodel look like in California?

Your construction budget and your permit/professional-service costs are separate line items. What $10,000 buys depends heavily on whether the project touches plumbing, electrical, walls, ventilation, or the room's layout.

What laws and building codes apply to bathroom remodels in California?

The California Building Standards Code, Title 24, sets the statewide framework, currently the 2025 Triennial Edition effective January 1, 2026. Cities and counties may add local administrative rules or amendments, so verify current requirements locally.

How long does it take to get a bathroom remodel permit in California?

Timing varies by jurisdiction, application completeness, plan complexity, correction cycles, and inspection scheduling. Rather than expecting a fixed timeline, ask your local building department for current review expectations.

Do bathroom remodel permits include plumbing and electrical work in California?

Plumbing and electrical work may fall under separate trade permits or a combined application, depending on the jurisdiction and project scope. Confirm the required permit structure with your local department before construction begins.
